Manage a deduplication project
how-to Steps to accomplish one task
On this page
- Generate matches
- Discard matches
- Edit a deduplication project
- Organize deduplication projects into folders
- Archive a deduplication project
- Duplicate a deduplication project
After you create and configure your deduplication project, you can begin the deduplication process to eliminate duplicates and produce a unified and accurate representation of a golden record.
In this article, you will learn how to generate and discard matches in the deduplication project, as well as how to keep your project organized and aligned with your deduplication goals.

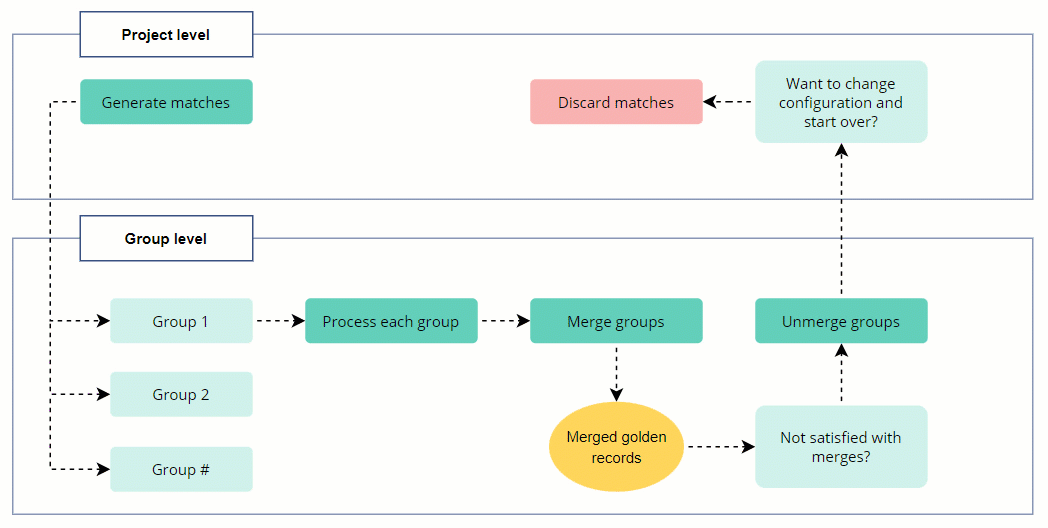

The primary action on the deduplication project level is the generation of matches. Its purpose is to analyze a specific set of golden records and detect potential duplicates based on your matching rules. If such duplicates are detected, they are organized into groups. The following diagram illustrates basic project workflow. For more information about project statuses, see Deduplication reference.

Instructions on how to process groups of duplicates, including merging and unmerging, are provided in the Manage groups of duplicates article.
Generate matches
The process of generating matches involves analyzing a specified set of golden records with the goal of finding duplicates among them based on your matching rules.
To generate matches
-

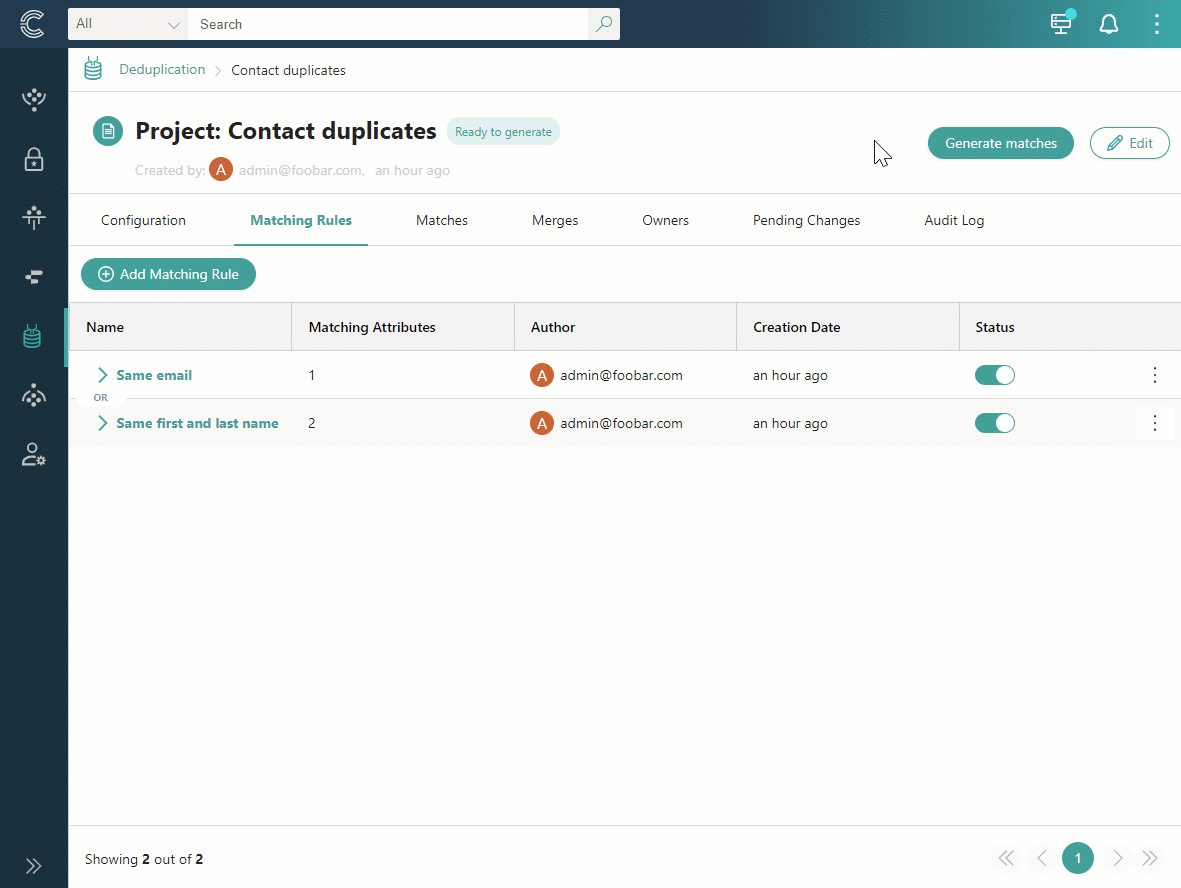

In the deduplication project, select Generate matches, and then confirm your choice.

During the process of generating matches, you can view the number of groups found as well as the percentage of golden records that have been checked for duplicates. When the process is complete, the groups of duplicates are displayed on the page. A group contains duplicate records that can be potentially merged into one golden record.
CluedIn records when generation started for the current result set. The deduplication project list exposes this as Last generation, which helps you understand how fresh a project’s matching results are and lets you sort projects by their most recent generation.
Next, process the groups of duplicates—open each group one by one to review duplicates and fix conflicting values.
Sorting and filtering of groups
You can sort the groups of duplicates using column headers—Name and Number of matches. These column headers contain small arrows pointing up and down. A green arrow pointing up means that column is sorted in ascending order. A green arrow pointing down means that column is sorted in descending order. To change the order, click on the grey arrow in the needed column header.
You can filter the groups of duplicates using the Min matches – Max matches slider. This allows you to focus on groups that contain a specific number of matches. For example, if you have a lot of groups of duplicates, you might want to start with small groups first. To do this, set the desired number of matches using the slider. Once you’ve processed the small groups, you can move on to larger groups by adjusting the slider accordingly.

Generate matches for multiple projects at once
From the list of deduplication projects, you can select multiple projects and generate matches for all of them at once, instead of opening each project individually.
-
On the navigation pane, go to Management > Deduplicate.
-
In the list of deduplication projects, select the checkbox next to each project that you want to generate matches for. You can also select the checkbox in the header row to select all projects on the page.
-
Near the upper-right corner of the list of deduplication projects, select Generate matches.
Match generation starts independently for each selected project; if it fails to start for one project, the rest of the selected projects are not affected.
Discard matches
If you want to change matching rules, modify project filters, or regenerate matches in the deduplication project, you can discard matches. This action does not affect merged golden records.
To discard matches
-

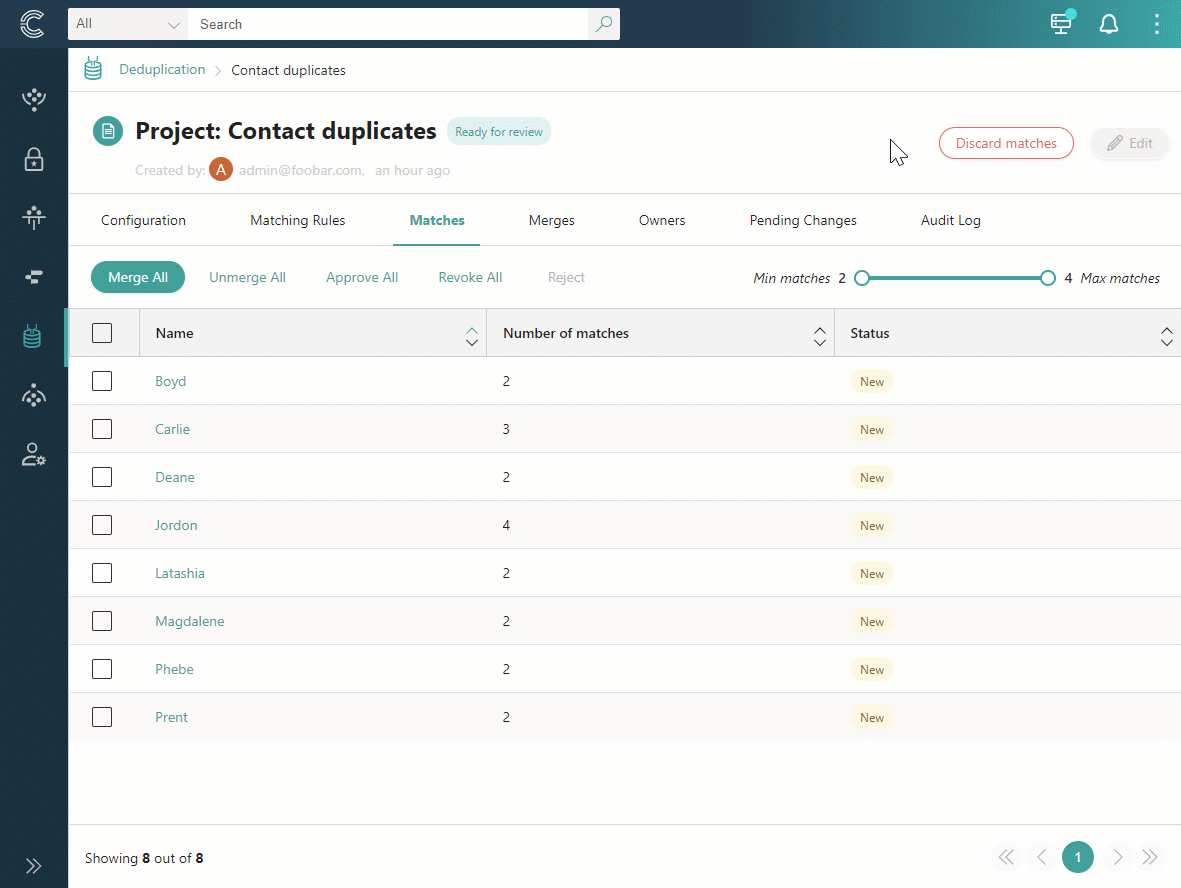

In the upper-right corner of the deduplication project, select Discard matches, and then confirm your choice.

The project status is changed to Ready to generate. Now, you can edit the project as needed and generate matches again.
Edit a deduplication project
You can edit a deduplication project only when its status is Requires configuration or Ready to generate. In other statuses, you need to discard matches before editing the project.
Editing a deduplication project involves two aspects:
-
Editing the project configuration: project name, image, business domain, or advanced filters, and description. For example, if you used advanced filters to narrow down the number of golden records for the project and you have reached the desired matching rules configuration, you can now modify the filters and run the project on the entire set of data.
-
Editing the matching rules configuration: change rule name; add rule; deactivate or delete the rule; modify matching criteria (edit, delete, add).
To edit the project configuration
-
In the upper-right corner of a deduplication project, select Edit.
-
Make the needed changes, and then select Save.

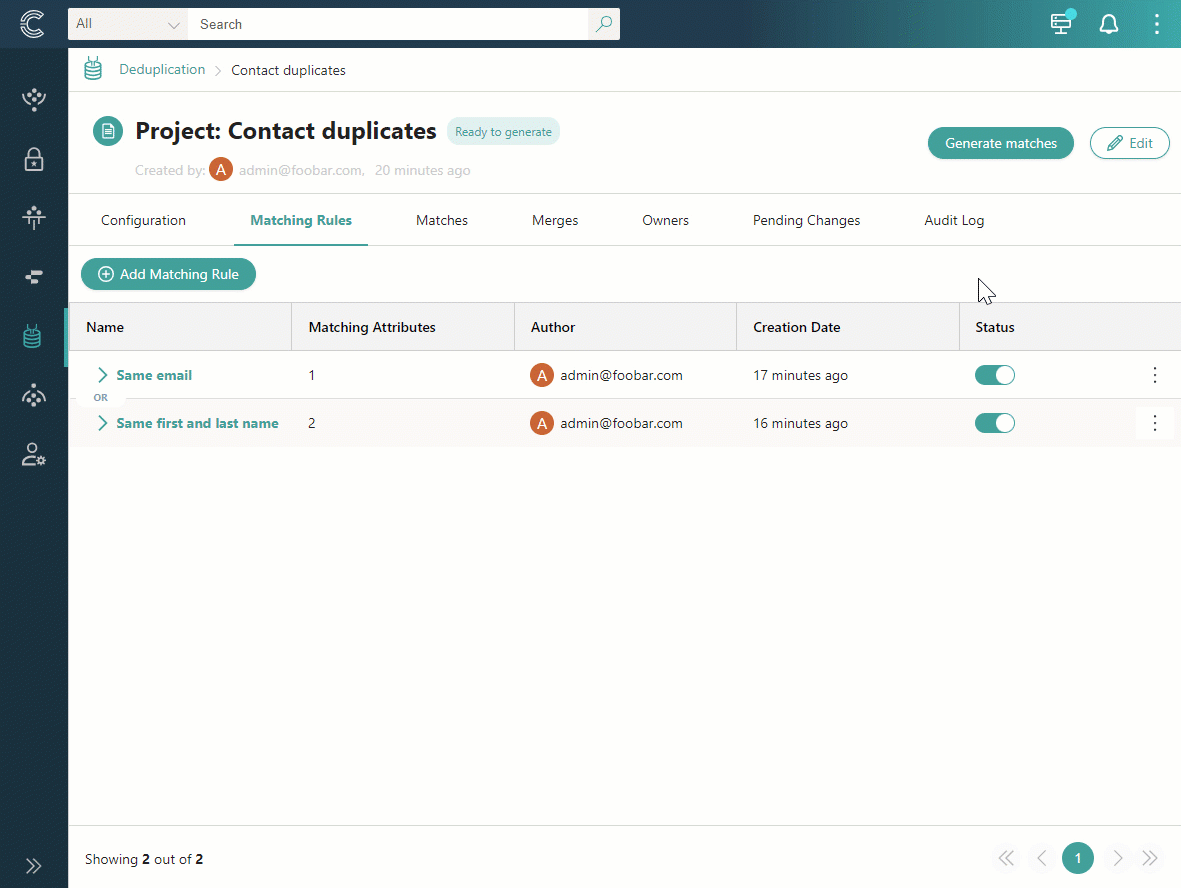

To edit the matching rules configuration
-
On the Matching Rules tab, in the Status column, do one of the following:
-
To change the rule name, select the vertical ellipsis button, and then select Edit name. Enter the new name and save your changes.
-
To deactivate the rule, turn off the toggle. Deactivated rules are not executed during the process of generating matches.
-
To delete the rule, select the vertical ellipsis button, and then select Delete and confirm your choice. If you delete the rule, it cannot be reverted.
-
To modify the matching criteria, expand the rule and select the vertical ellipsis button in the needed row. Then select the needed action: Edit or Delete.

-
You can also add new matching criteria to the rule. To do that, expand the rule, and then select Add Matching Criteria. When you are satisfied with the project and matching rules configuration, proceed to generate matches.

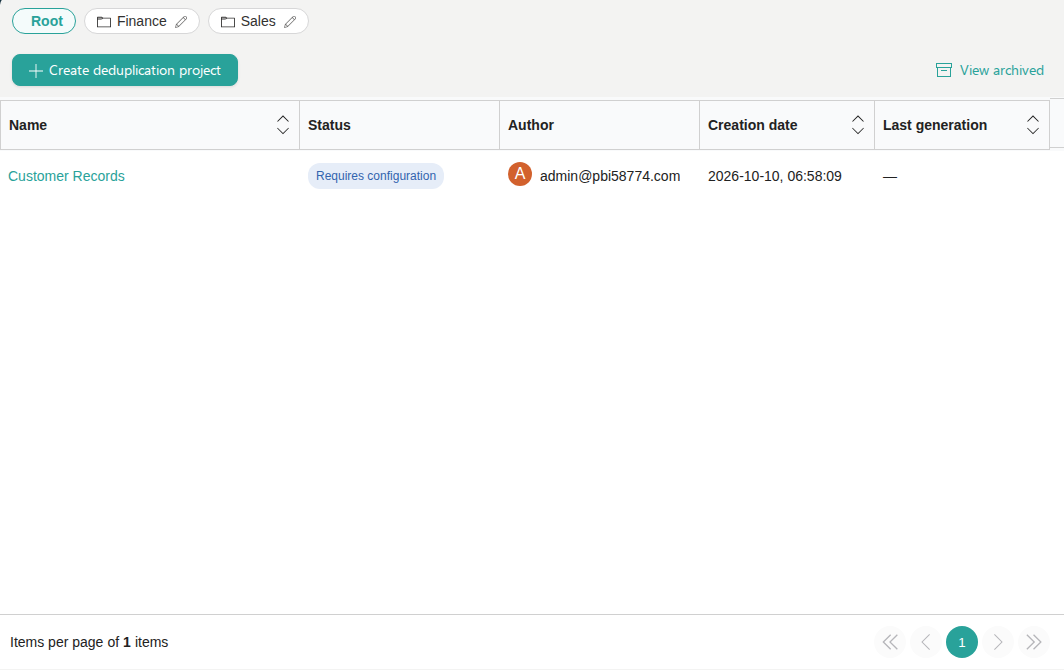

Organize deduplication projects into folders
You can use folders to organize deduplication projects—for example, by business domain or by team. Deduplication projects that aren’t assigned to a folder appear in the root list.

To assign a deduplication project to a folder
-
In the list of deduplication projects, find the project that you want to move. Then, open the three-dot menu for the project, and select Move to folder.
-

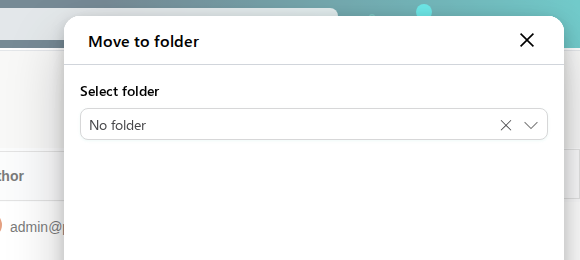

In Select folder, choose an existing folder, or type a new folder name to create one.

-
Select Save.
You can also drag a deduplication project from the list and drop it onto a folder in the folder bar to move it there.
To view the deduplication projects in a folder
-

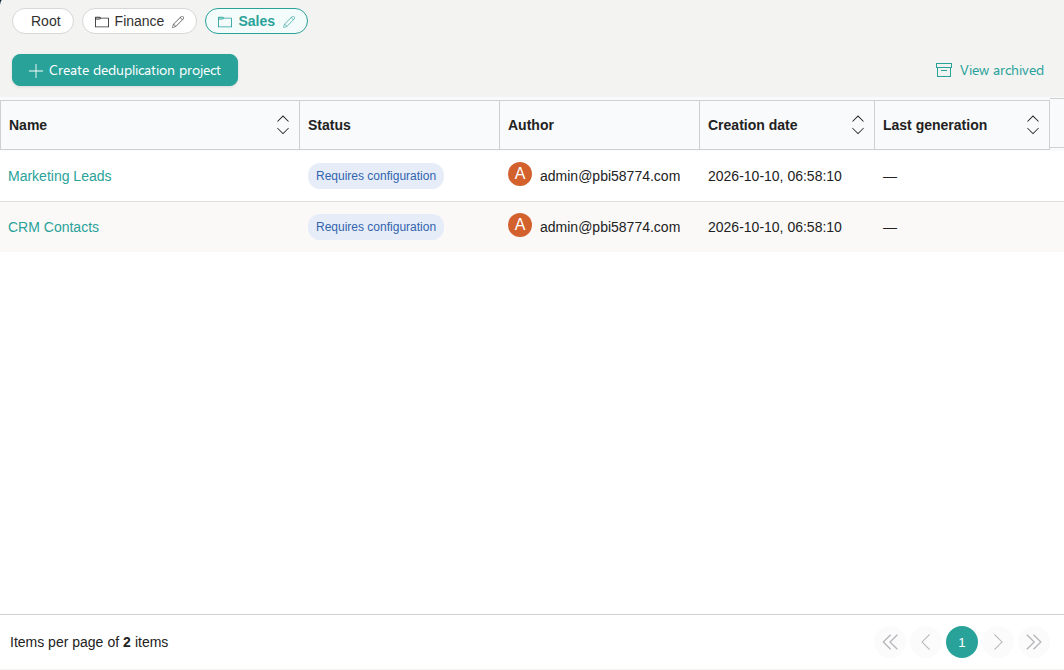

In the folder bar, select the folder that you want to view.

Select Root to return to the list of deduplication projects that aren’t assigned to a folder.
To move a deduplication project to a different folder
- Open the three-dot menu for the project, select Move to folder, choose the new folder, and then select Save. You can also drag the project onto a different folder in the folder bar.
To remove a deduplication project from its folder
- Open the three-dot menu for the project, and select Remove from folder. The project returns to the root list. You can also drag the project onto Root in the folder bar.
To rename a folder
- In the folder bar, select the pencil icon next to the folder, enter the new name, and then select Save. Renaming a folder updates it for every deduplication project assigned to it.
Archive a deduplication project
You can archive a deduplication project if you no longer need it or if you created it by mistake. You can also archive a deduplication project if you’re confident that you won’t need to run it again in the future. Archiving does not affect merges that have been submitted to CluedIn.
After a deduplication project is archived, it cannot be unarchived. Archived projects are available only for viewing.
You can archive a deduplication project only when its status is Requires configuration or Ready to generate. In other statuses, you need to discard matches before archiving the project.
To archive a deduplication project
-

In the upper-right corner of a deduplication project, select Edit > Archive. Then, confirm that you want to archive the project.

The status of a deduplication project becomes Archived, and you can no longer work with the project.
To view an archived deduplication project
-

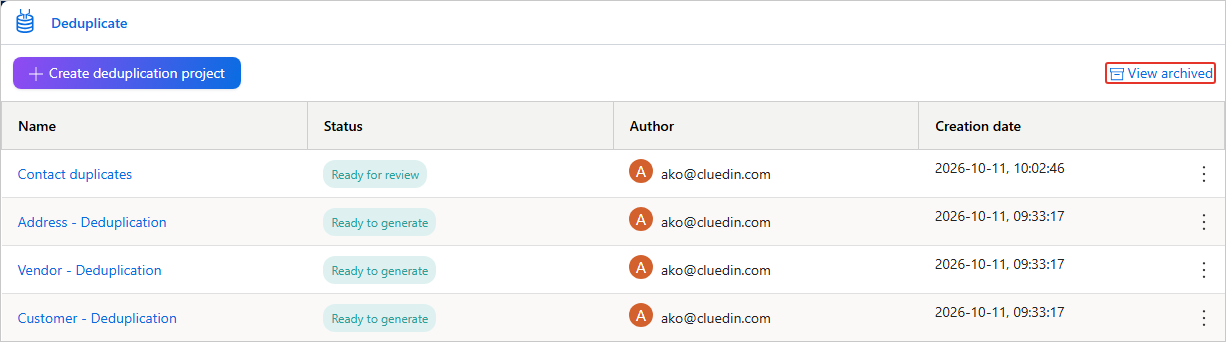

In the upper-right corner of the Deduplication page, select View Archived.

-
From the list of archived deduplication projects, select the one that you want to view.
Duplicate a deduplication project
Duplicating a deduplication project means creating a new deduplication project with the configuration of the existing project. This configuration includes filters and matching rules but does not include the deduplication activities performed in the project. By activities, we mean generated matches and merges.
You can duplicate a deduplication project if you want to:
- Use the same matching rules for a different set of golden records. In this case, you only need to modify the filters in the duplicated project.
- Use different matching rules for the same set of golden records. In this case, you only need to modify the matching rules in the duplicated project.
Duplication is a beta feature. To access it, go to Administration > Feature Flags, and enable the Duplicate Actions feature.

To duplicate a deduplication project
-

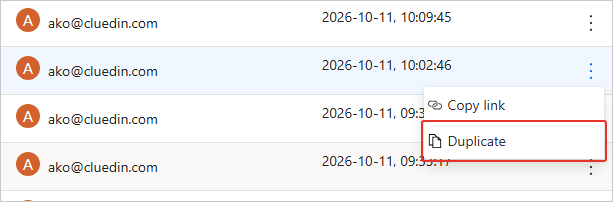

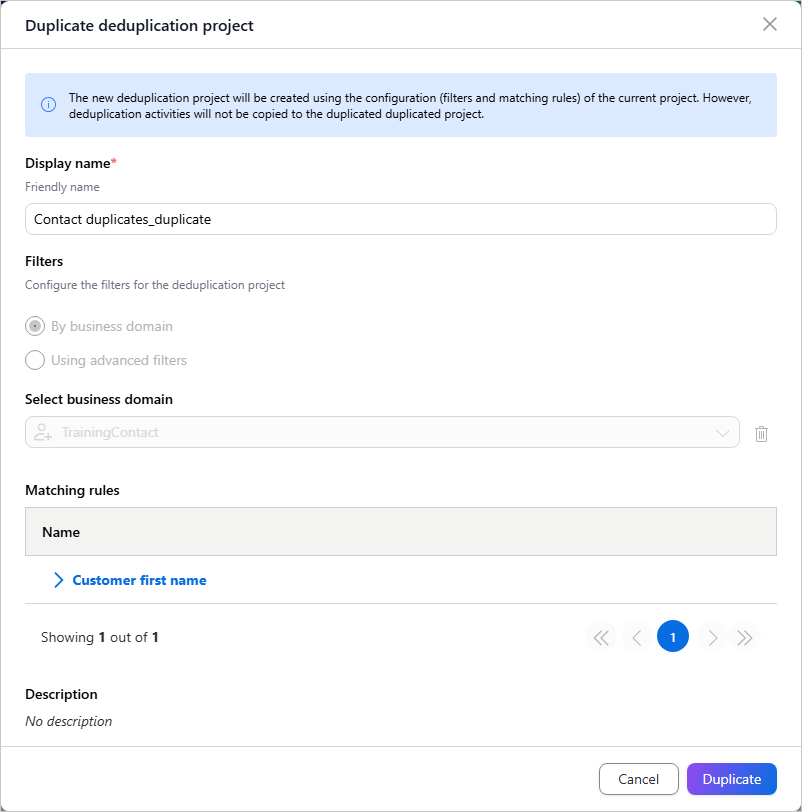

In the list of deduplication projects, find a project that you want to duplicate. Then, open the three-dot menu for the project, and select Duplicate.

-
In Display Name, review the default name of the new project and modify it if needed. The default name is created by adding _duplicate to the name of the project that you’re duplicating.
-
In Filters, review the filters that will be duplicated for the new project.
-
In Matching Rules, review the list of matching rules that will be duplicated for the new project. To view the details of a specific matching rule, select the angle bracket (>) next to the name of the matching rule.

-
Select Duplicate.
The new deduplication project is created, and it has the Ready to generate status. Now, you can modify the deduplication project configuration as needed. When you reach the desired configuration, generate matches, and then start working with the groups of duplicates.
